Phases, tasks and dependencies
Lay out a project in phases, add tasks with assignees, estimates per person, checklists and files, set dependencies with lag and see the critical path, repeat tasks, ask for approval, work in bulk, import and export, and turn tasks into tickets and back.
The Tasks tab is where a project's work lives. Tasks are grouped by phase, and each one opens in a side panel with everything about it.

Phases

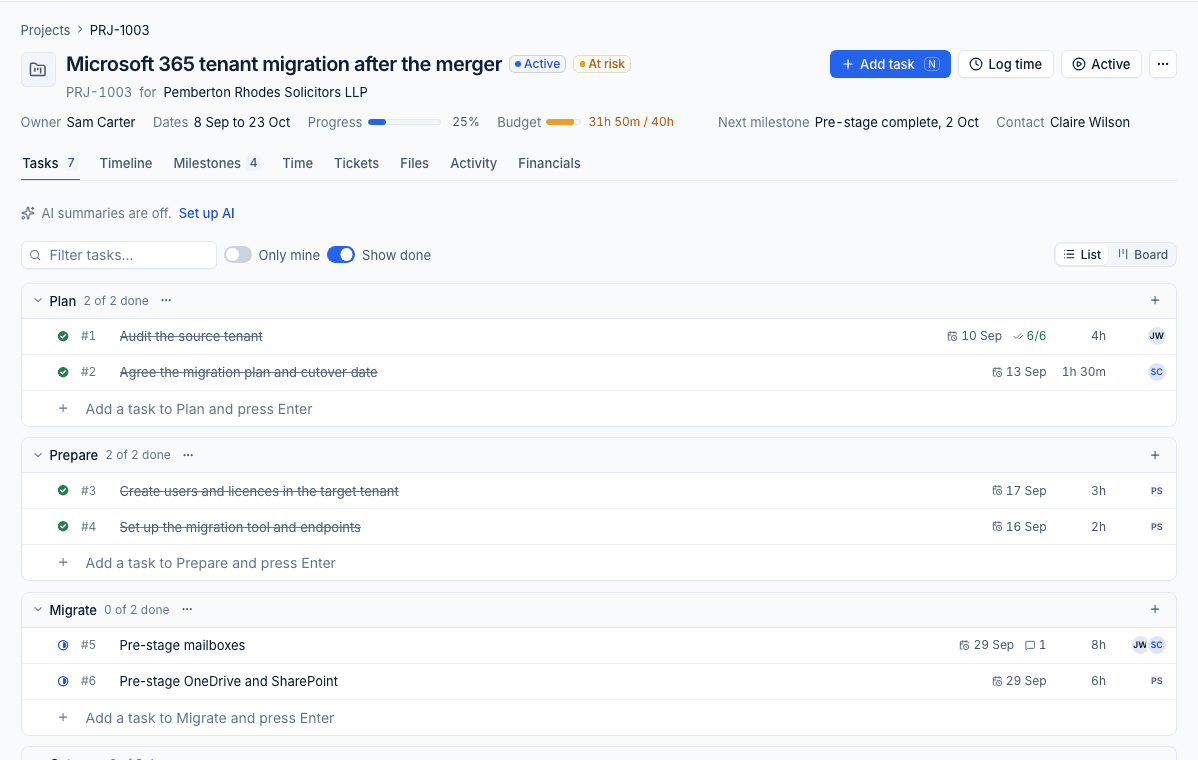

A phase is a stage of the work, such as Plan, Migrate or Tidy up. Each shows how many of its tasks are done.
- Add a phase at the bottom of the list.
- The phase's ... menu renames it, moves it up or down, sets how it is billed and its budget, makes it wait for information from the customer, or removes it.
- Drag a task's handle (or use
Alt+UpandAlt+Down) to reorder it or move it into another phase.
Add tasks
- Type into Add a task to [phase] and press Enter under any phase for a quick task.
- Press Add task (or
n) at the top of the project for the full form.
Use Filter tasks, Only mine and Show done above the list to narrow it down, and j and k to move between tasks, Enter to open one and . to change its status. While a filter is on, phases with nothing to show are hidden, with a line at the bottom that shows them again.
Bulk changes
Tick the tasks you want (or select all), then use Bulk actions to change their status, priority, assignees, phase, due date or sharing in one go. Each task is changed as if you had done it by hand, so notifications and health follow, and one Undo in the message puts them all back. The same works on Projects > All tasks across every project.
The task panel
Click a task to open it in a panel over the project. Its reference (for example PRJ-1003 #8) is at the top.


- Status and priority: click the status, or press
.and then1to5. Priorities are Low, Normal, High and Urgent. - Assignees: one or more people. Each is told in their inbox.
- Start and Due: the dates the task runs between.
- Phase and Milestone: where the task belongs.
- Time: the estimate, the time logged so far against it, and Log time.
- Estimate and what is left: an estimate for each assignee (the task's estimate is then their sum), the time each has logged, and Left to do with who set it and when. Workload and resource planning use what is left when it is set.
- Needs approval by: someone who must approve the task before it counts as done (see Task approval below).
- Waits for information: an information set the task waits for (see Waiting for the customer's answers below).
- Customer to-do: makes the task something you need from one of the customer's contacts. They see it in the portal and get an email, with a reminder before it is due.
- Repeats: makes the task recur (see Recurring tasks below).
- Expenses: parts, parking or mileage spent on the task, with Add expense.
- On the portal: off (Internal) by default. Turn it on to share the task with the customer on the portal, where they can comment on it.
- Description: what needs doing and how you will know it is done. Press
eto edit the title. - Checklist: type an item and press Enter. Tick items off, edit them or drag them into order.
- Links: the devices, sites, contacts, tickets, documents, records and credentials the task is about.
- Files: drop files on the panel or pick them, up to 25 MB each.
- Comments and the task's History at the bottom.
People with View can change the status, tick the checklist and log time on tasks assigned to them. Everything else needs Manage.

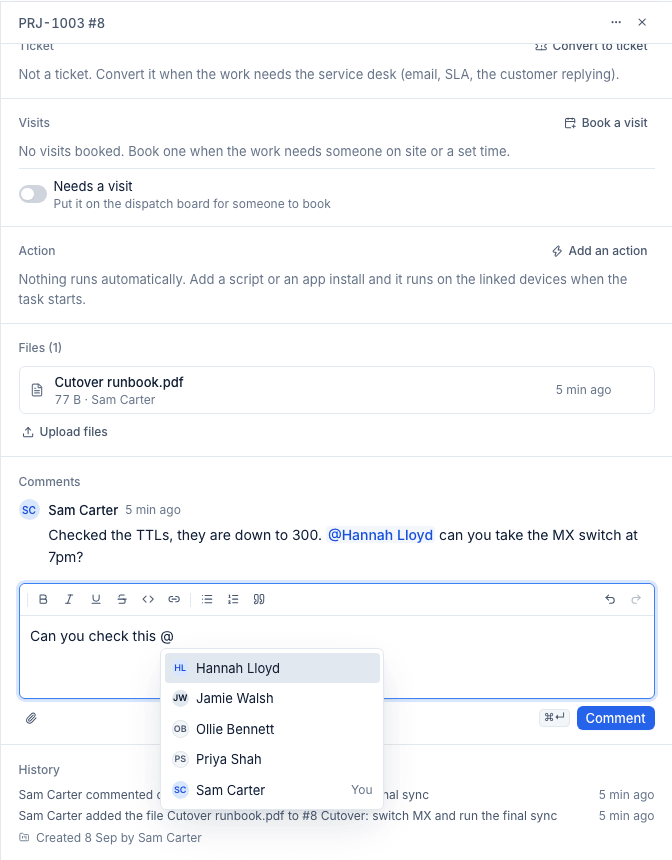

Comments and @mentions
Press c to comment. Type @ to mention someone: they get a notification that takes them straight to the task. On a task shared with the customer you choose whether a comment is internal or one the customer sees.
The project's team and its followers (anyone who pressed Follow on the project) are told what the owner is told, never twice. Template tasks can go to "whoever has the role" on the team, such as the project lead.

Dependencies

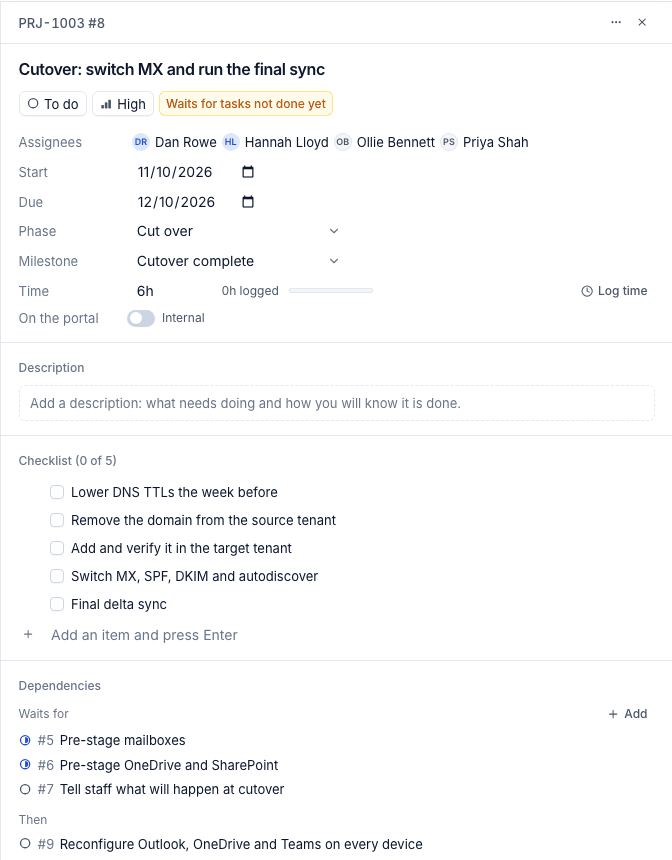

A dependency says when one task can start or finish relative to another. Open the task and, under Dependencies, press Add next to Waits for and choose the tasks it waits on. Then lists the tasks waiting on this one.
Click a dependency to set its Kind of dependency and its Lag (days):
| Kind | Meaning |
|---|---|
| Finish to start | Starts once the other is done (the default) |
| Start to start | Starts once the other has started, such as pre-staging OneDrive two days after the mailboxes start |
| Finish to finish | Finishes once the other has finished |
Lag is a whole number of days, up to 365 either way. A negative lag is a lead: the task can start that many days early.
- A task waiting on unfinished work shows Blocked in the list, on the board and in My work. When the last task it waits for is done, the assignees are told it can start.
- Dependencies stay within one project, and loops are refused with the path, such as "That would make a loop: A waits for B which waits for A".
- Moving a task's dates on the timeline can move every task that waits on it by the same number of days. See The board, the timeline and My work.
Working days and the critical path
Dates, lag and the knock-on from moving a task count working days: your working week, less public holidays and office closures. A project that runs every day (24/7 work) can count calendar days instead, set when you create or edit it. Changing this never moves dates already set.
The Critical path in the project header shows when the chain of tasks with no slack ends, for example "Ends 13 Nov (target 18 Nov)". Turn on Critical path on the timeline to highlight those tasks. When the critical path ends after the target date, the project counts as late and the health reason names the task that pushes the end out.
Waiting for the customer's answers
A task or a whole phase can wait for an information set the customer answers in the portal, so nobody starts porting numbers before the porting details are in.
- A task: open it and choose the set under Waits for information.
- A phase: open the phase's ... menu, choose Waits for information and pick the Information set. Every task in the phase then waits.
While the request for that set is not complete, the task shows Waiting for information from the contact who has it (or says the set has not been requested yet, with a pointer to the project's Information tab, where you send it). When the customer's answers are complete, the wait ends and the people on the task are told they can start. Template tasks and phases can carry the same wait, so every project made from the template is gated the same way.
Sending the requests is covered in Creating a project, and using the answers in task titles, descriptions and checklists in Using information request answers.
Task approval
Some tasks need a second pair of eyes, such as a cutover runbook or a firewall change. Set Needs approval by to a person, the project's owner or a team role.
- When someone other than the approver marks the task done, it waits as Awaiting approval and the approver is told.
- The approver opens it and presses Approve, or Send back with a note. Sent back, it returns to in progress with the note as an internal comment for the people doing it.
It only counts as done once approved. Tasks waiting for your approval come first in My work. Automation can check whether a task needs approval.
Recurring tasks
Use Repeats on a task for work that comes round, such as a weekly call or a monthly patch review: Daily, every so many weeks on chosen days, or Monthly on a day, until a date or the project's target date. Templates can have repeating tasks too.
- Completing one occurrence makes the next, with the same people, checklist and estimate. A series never has more than one open occurrence.
- An occurrence opens on its start date. Completing it before then asks Complete early? first, and only the next occurrence can be completed early, so a series can never be ticked off months ahead by mistake.
- Recurring work is left out of the critical path, so it never makes the project late on its own. If a series runs past the target date, its band on the timeline turns amber and the Repeats section says so; set an end date to stop it at the target.
Stop repeating ends the series.
Import and export tasks
- Import on the Tasks tab takes a CSV or Excel file (a header row, then one task a row) or a Microsoft Project XML file. In a Project file, summary tasks become phases, work becomes the estimate, and links keep their type and lag. Match the columns, check the preview, then import.
- Export tasks (CSV) downloads the project's tasks.
- Templates can be exported as a file and imported into another install with Import a template. See Project templates.
Visits for a task
When a task needs someone on site, the Visits block in the panel books it:
- Book a visit opens the booking form with the customer, site and contact from the project, the task's assignees and the time left on its estimate.
- Needs a visit puts the task on the dispatch board, so whoever plans the diary can drag it onto a technician.
When the visit is completed, its time is logged against the task. See The dispatch board.
Tasks and tickets
Some work starts as a project task and needs the service desk; some starts as a ticket and belongs in a project.
Turn a task into a ticket
Under Ticket in the task panel, press Convert to ticket. The ticket takes the task's title and description, the project's customer and site, the devices linked to the task and the first assignee. The two are linked both ways and the ticket is attached to the project. From then on, resolving or closing the ticket completes the task.
Turn a ticket into a task

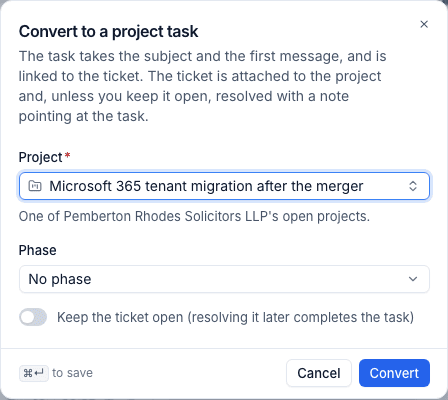

- On the ticket, open the ... menu and choose Convert to project task.
- Choose the Project (one of the customer's open projects) and the Phase.
- Leave Keep the ticket open off to resolve the ticket with a note pointing at the task, or turn it on to keep working it.
- Press Convert.

The task takes the ticket's subject, first message, assignee and devices, and the ticket's time moves to the project.
Attach a ticket
To keep a ticket as a ticket but count its time against a project, choose Attach to project from the ticket's menu. The ticket's Project block then shows the project's health and progress, and the project's Tickets tab lists it.
Related: Creating a project, Time, budgets and billing.
