Docs

Project team and resource planning

Give a project its team with roles, plan each person's hours week by week, spot people booked beyond their working hours, and find projects that still need people.

Each project has a team, and each person on it can have hours planned per week. Resource planning then adds those hours up across every open project and sets them against each person's working hours, so you can see who is over-committed and which projects are short of people before it becomes a problem.

The project team

Open a project's Team tab.

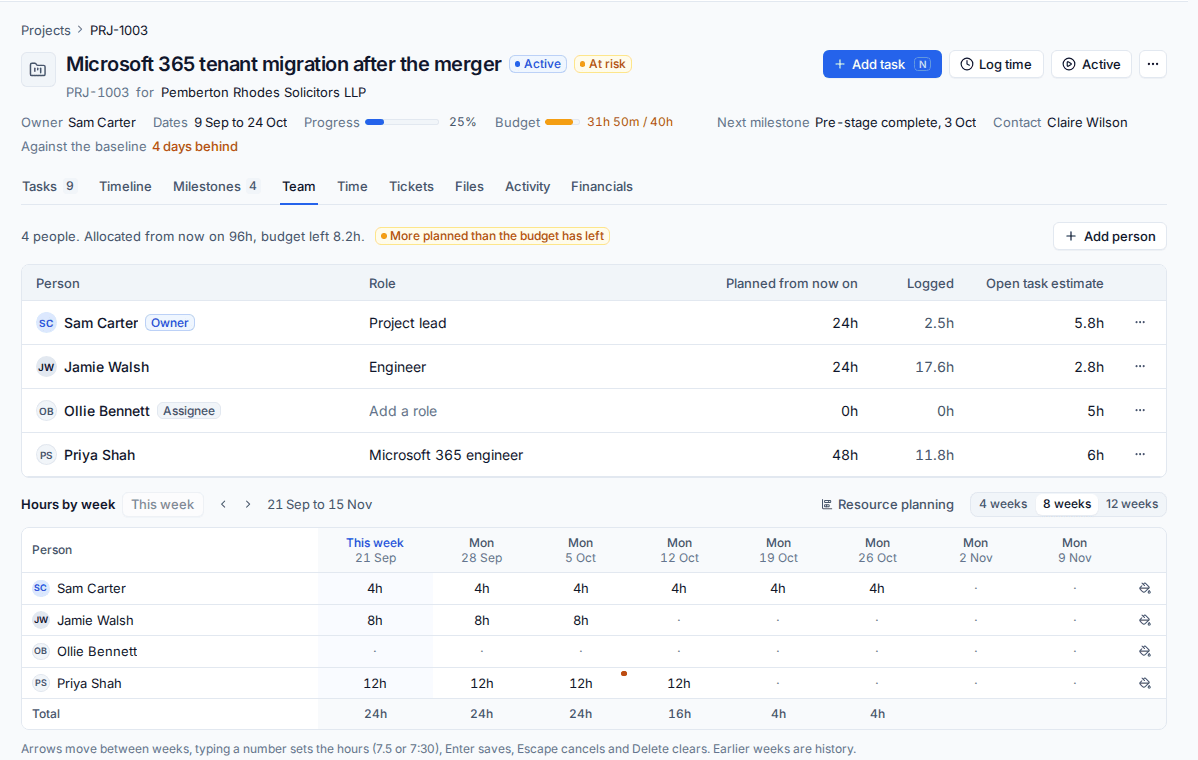

A project team with roles, and hours planned per week
A project team with roles, and hours planned per week

The team is everyone who works on the project:

  • the Owner, always listed first;
  • every Assignee of a task (they count without being added);
  • anyone you add with a role or hours.

The table shows each person's Role, the hours Planned from now on, the time they have Logged on the project and their Open task estimate (what is left on their open tasks here; a task shared between several people counts an equal share each).

The line above sums it up, for example "4 people. Allocated from now on 72h, budget left 16.2h." A More planned than the budget has left warning shows when it applies.

Add someone

  1. Press Add person.
  2. Choose them from your staff and give them a Role, for example "Project manager" or "Engineer". The roles come from Settings > Projects, under Project team, so every project uses the same names.
  3. Optionally enter Hours a week to plan them now.
  4. Press Add to the team.

They are told in their inbox that they have been added (unless they added themselves). To change a role, pick another from the Role list in the table. Each person's ... menu has Fill (the same Hours a week from the week you choose, for as many weeks as you say; 0 clears them) and Remove from the team. Removing someone clears all their hours on the project; the owner and assignees stay on the team as long as they own or work its tasks.

Plan hours by week

Hours by week is a grid of people against weeks. Choose 4 weeks, 8 weeks or 12 weeks, move earlier or later with the arrows, and press This week to come back.

  1. Click a cell (or move to it with the arrow keys, Home and End).
  2. Type the hours. Tenvara reads "7.5", "7,5", "7:30", "7h 30m" and "45m".
  3. Press Enter to save and move down, or Escape to cancel. Delete clears a cell.

Hours are planned per week (Monday to Sunday), at most 168 in one week. Weeks that have passed and people who have left are read only. Only planned, active and on hold projects take hours.

A red marker on a cell means the person is over their working hours that week across all projects. Hover it to see why, for example "32h allocated across 3 projects, 30h capacity".

Roles and followers

Team roles do more than label people. Template tasks can be given to whoever has a role ("the project's engineer"), so a project made from a template assigns its tasks as soon as you fill the roles, and a task can need approval by a team role.

Anyone can press Follow on a project to be told what the owner is told without joining the team. The team and followers are never told the same thing twice. Projects I follow is a filter on the project list.

Estimates per person

When a task has several assignees, give each their own estimate in the task panel under Estimate and what is left; the task's estimate is their sum. The Open task estimate column, Workload and resource planning then use each person's own share, and what is Left to do once someone sets it. The Estimate accuracy tab of Reports > Projects compares estimates with the time actually logged by person, template and task, and a template can refine its estimates from the average actual time on its last completed projects.

Tip: Templates carry no team. A project made from a template starts with its owner and assignees and no hours, so plan the hours once the dates are set.

Resource planning across projects

Open Team > Resource planning, in the Schedule group of the Team area. The Resource planning button on the project list and on a project's Team tab opens the same page, and so does Cmd+K or Ctrl+K.

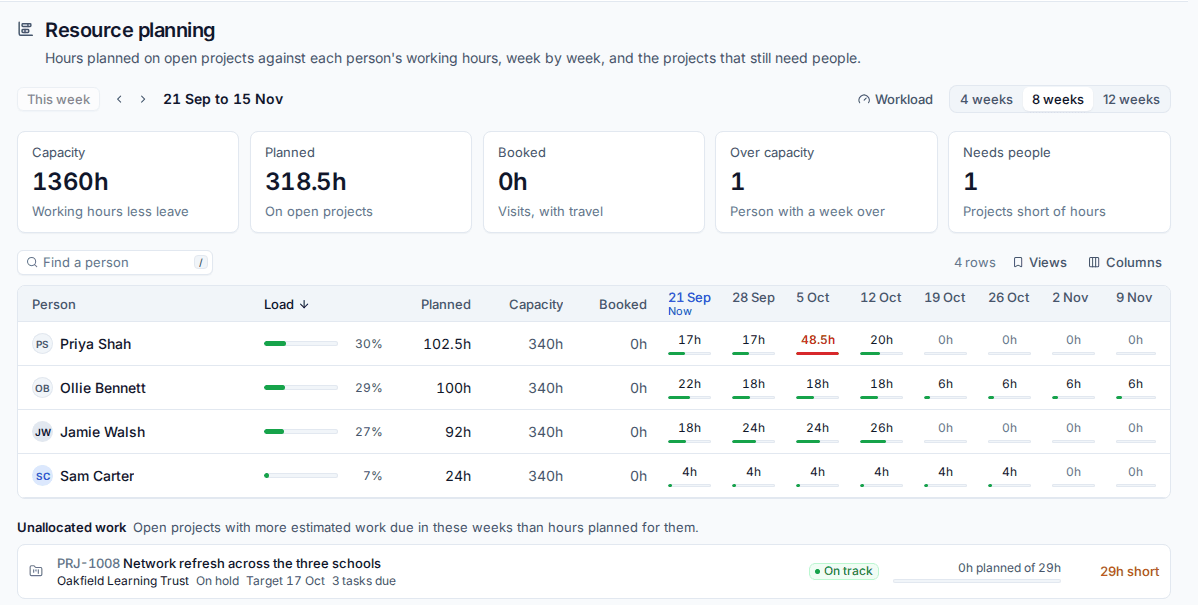

Resource planning: capacity, planned and booked hours per person per week
Resource planning: capacity, planned and booked hours per person per week

The figures at the top show:

  • Capacity: everyone's working hours in the weeks shown, less public holidays, office closures and approved leave;
  • Planned: hours planned on open projects;
  • Booked: visits in the diary, with their travel;
  • Over capacity: people with at least one week planned beyond their hours;
  • Needs people: projects short of planned hours.

The table has a row per person with their load, planned, capacity and booked hours, and a bar per week of planned against capacity. Click a person to see their hours by project and week in a side panel, with links to each project's Team tab. Press T for this week, and the left and right arrows to move by the weeks shown.

Capacity comes from each person's working hours in Scheduling (or your business hours if they have none), in their own time zone. See Working hours, leave and skills.

Unallocated work

Unallocated work lists open projects whose remaining task estimates due in the weeks shown come to more than the hours planned for them, most short first. For example "0h planned of 29h, 29h short" means the tasks need 29 hours and nobody has been given time for them.

Workload

Team > Workload looks at the near term: for each person, their capacity, booked visits, open tickets and the time left on their open project tasks due in the period, spread over the working days before each task is due. It links to resource planning with Plan ahead in Resource planning.

Related: The board, the timeline and My work, The dispatch board.
